Project Overview
Construction of the Black Creek Greenway Renovation and Cary Parkway Pedestrian Bridge at Black Creek Projects started in June 2024. These projects will improve and rehabilitate Black Creek Greenway from West Dynasty Drive to Old Reedy Creek Road and complete an existing sidewalk gap along Cary Parkway over Black Creek.
The construction duration is three years and is taking place in three phases to help minimize impacts to greenway users. Each phase will require closing and detouring that section of the greenway while the other sections of greenway remain open. Each phase includes contractor incentives for early completion.
Crowder Construction Company has been hired to complete the project.
Monthly Construction Updates
Phase 2 Construction Update – July 2025

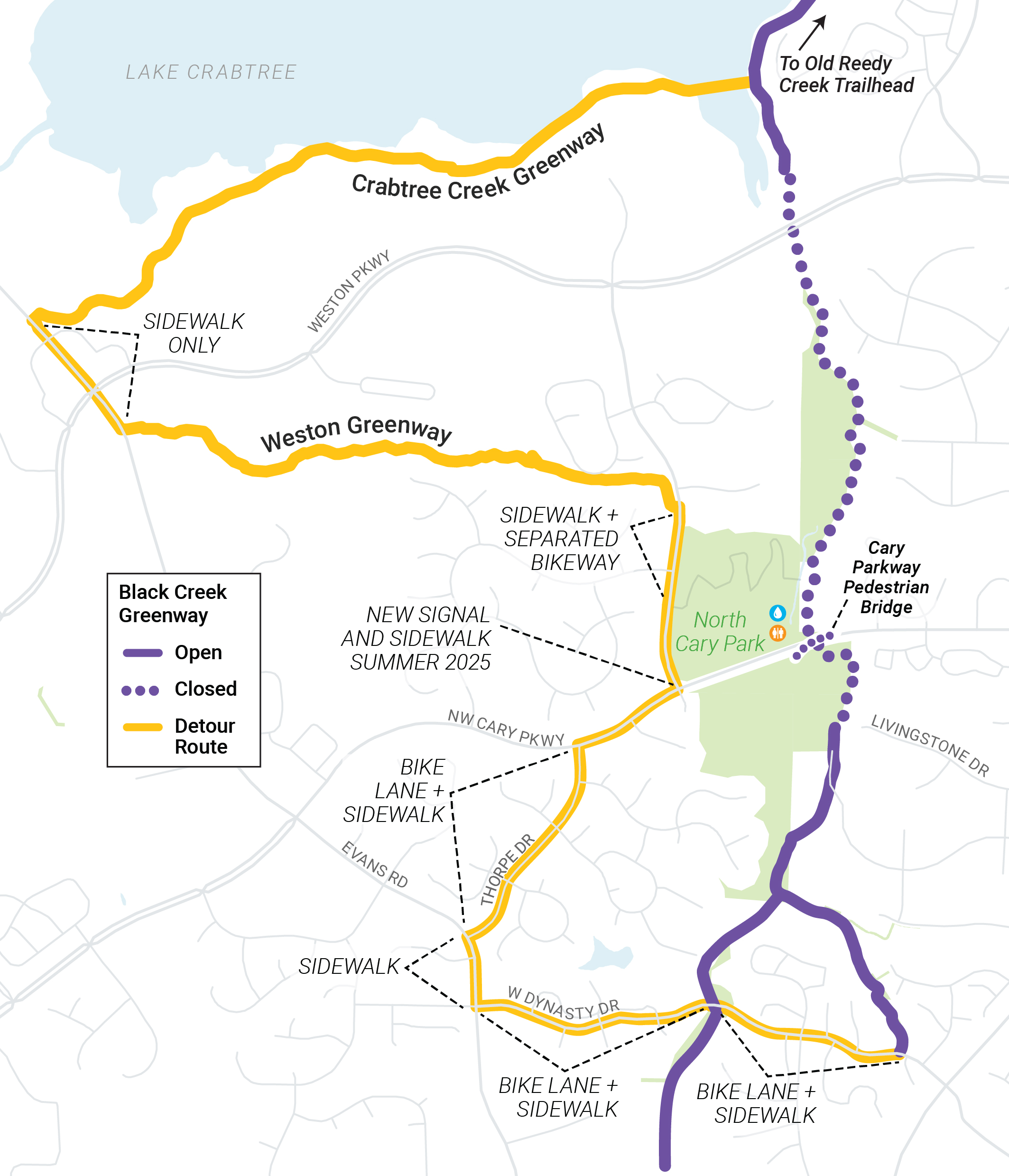

Black Creek Greenway, from the North Cary Park access to Weston Parkway will be closed and under construction in August.
Phase 1 Construction Update – July 2025
Black Creek Greenway, from West Dynasty Drive to Livingstone Drive will be completed and reopened in August.

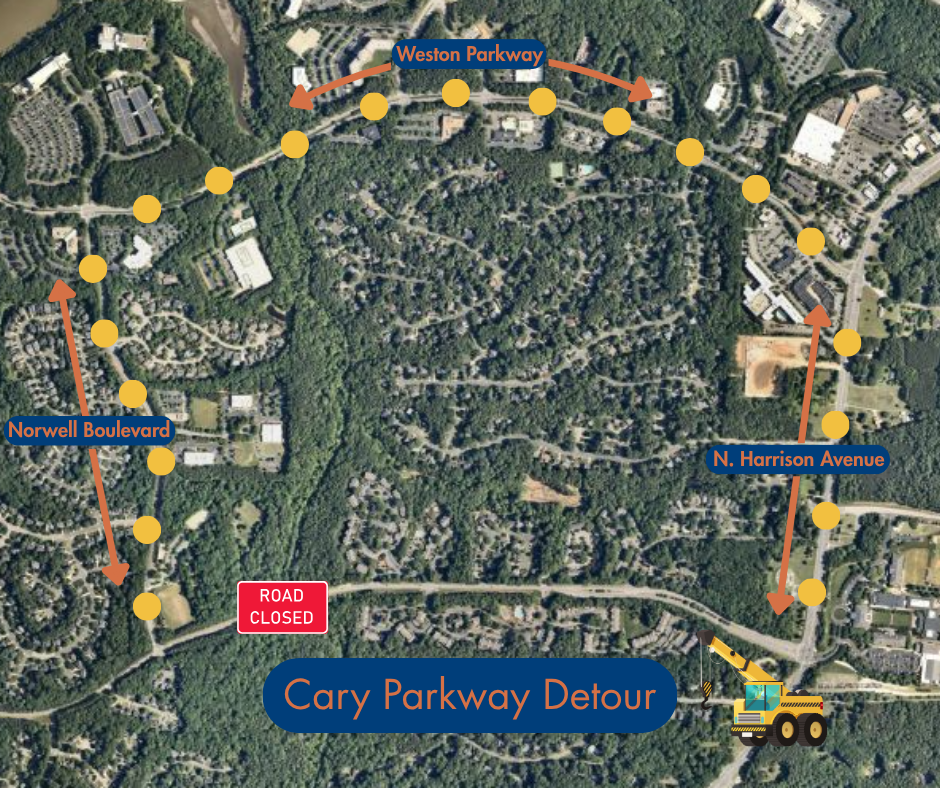

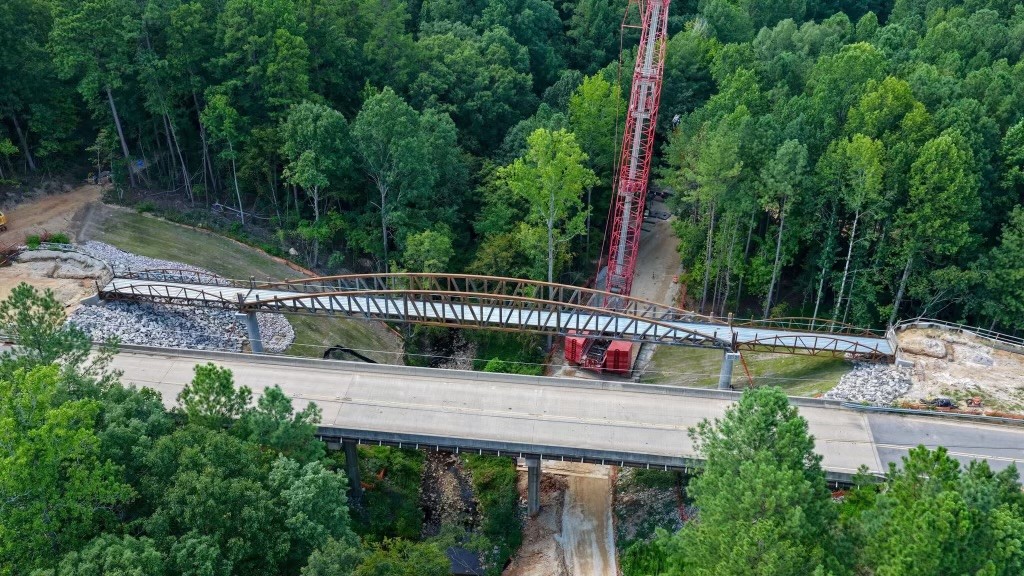

The Cary Parkway Pedestrian Bridge at Black Creek is scheduled to be installed during the week of July 21st. This work will require closing NW CPW for approximately 7 days beginning after the morning commute on July 21st. Traffic will be detoured to Norwell Drive, Weston Parkway and Harrison Avenue. Local traffic will be maintained. The bridge is scheduled to be completed and open before the end of 2025.
Black Creek Greenway from Livingstone Drive to the North Cary Park access will be reopened after the Cary Parkway Pedestrian Bridge at Black Creek has been opened.





Phase 1 Construction Update – May 2025

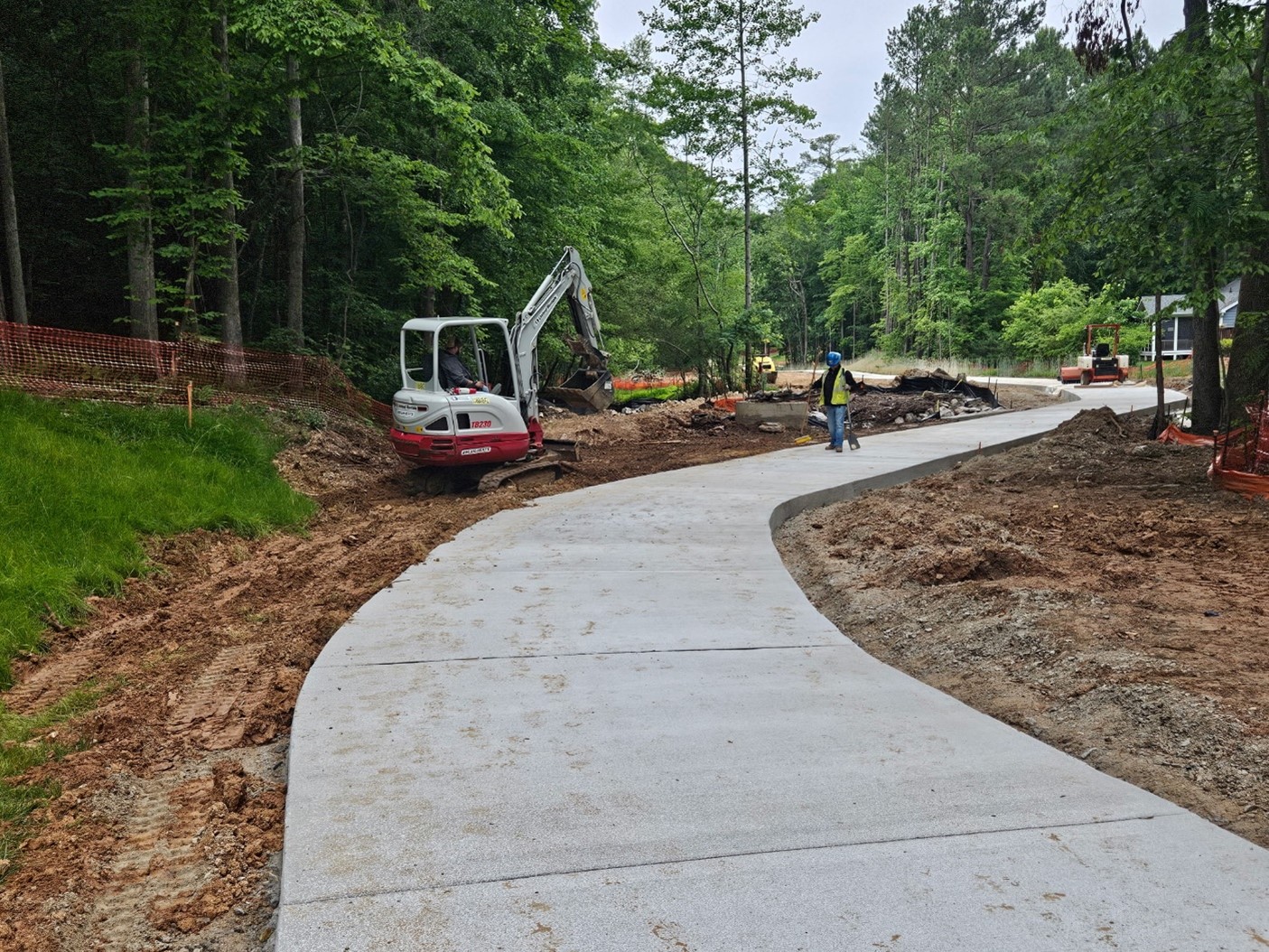

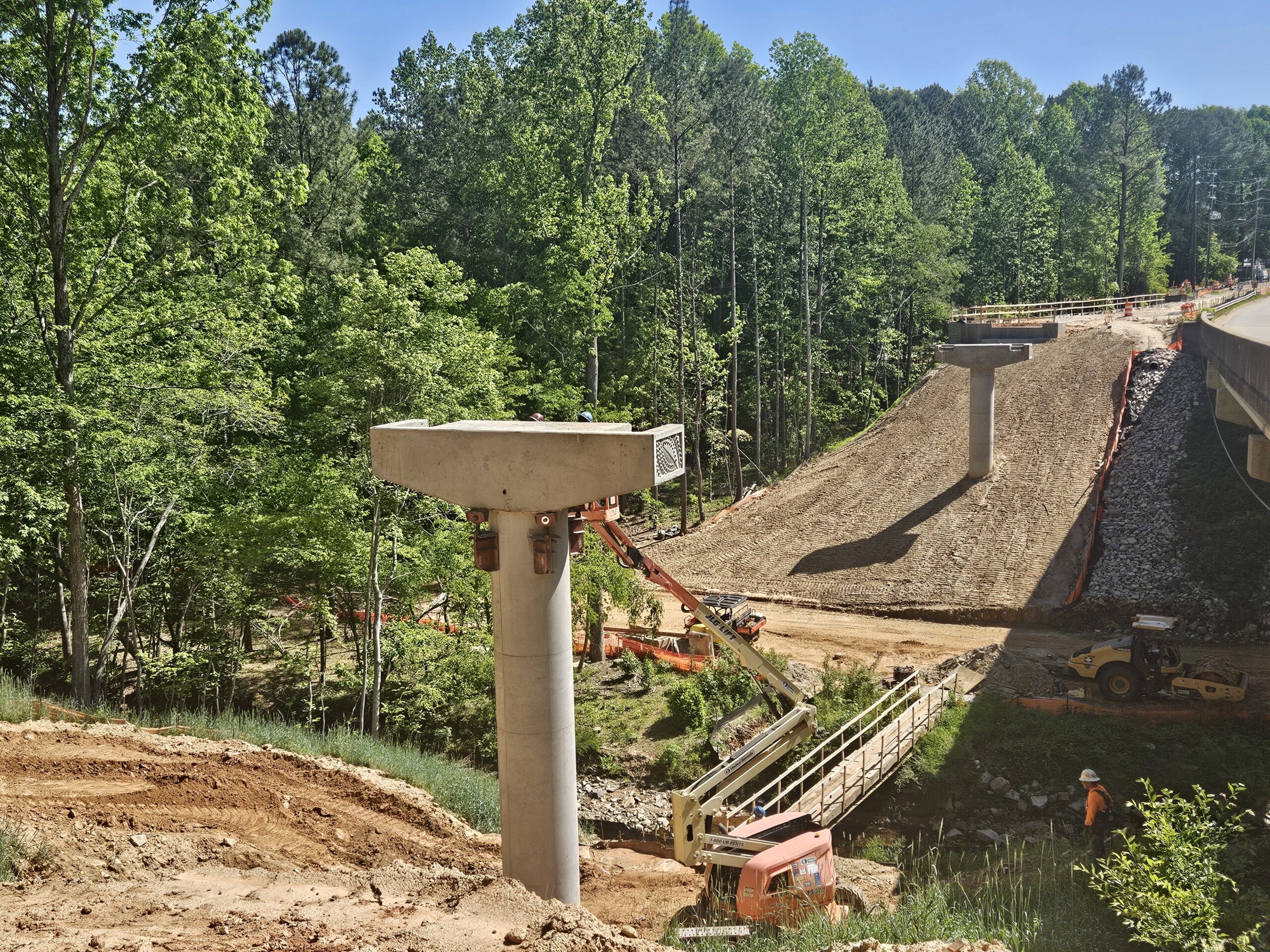

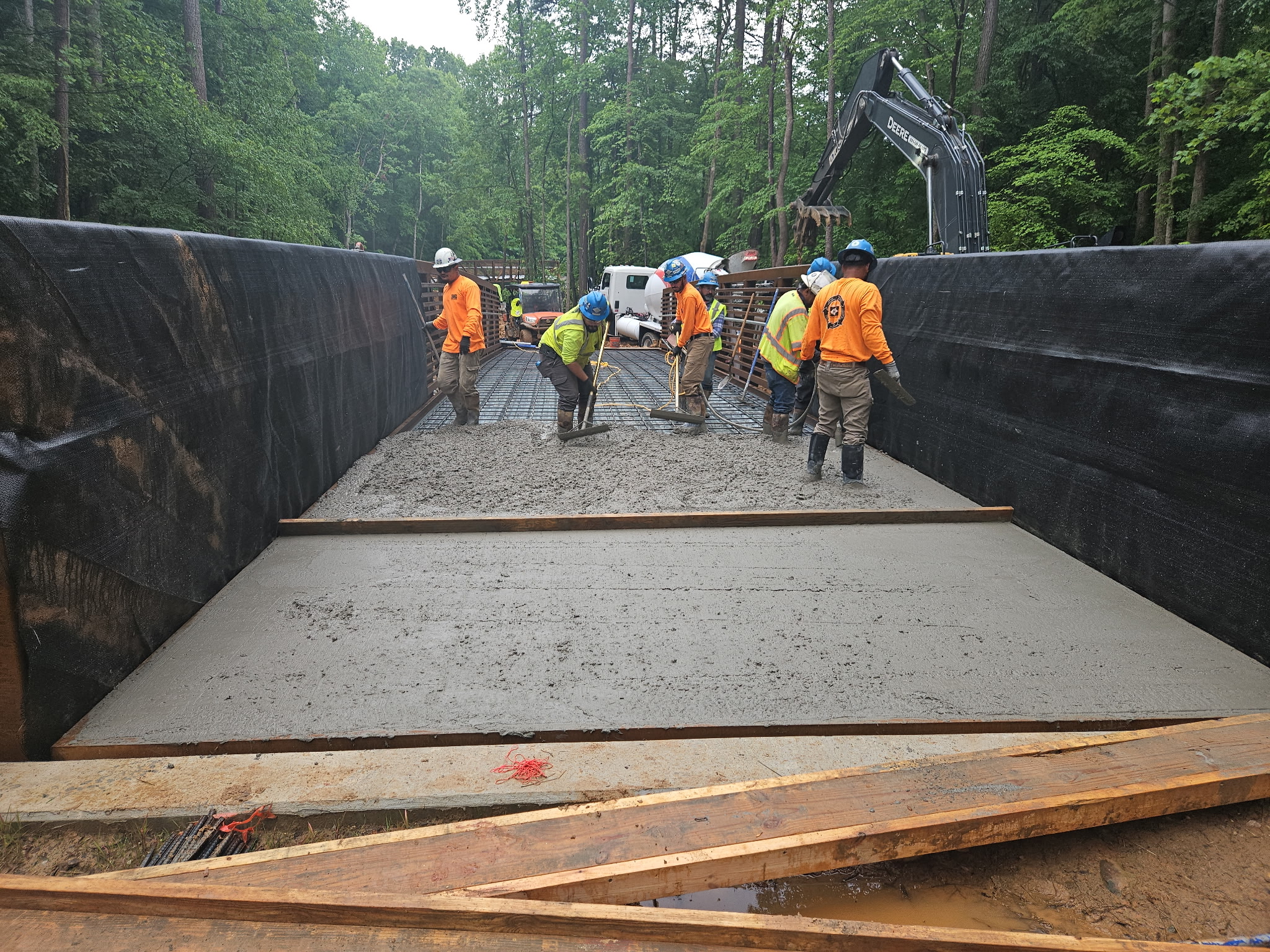

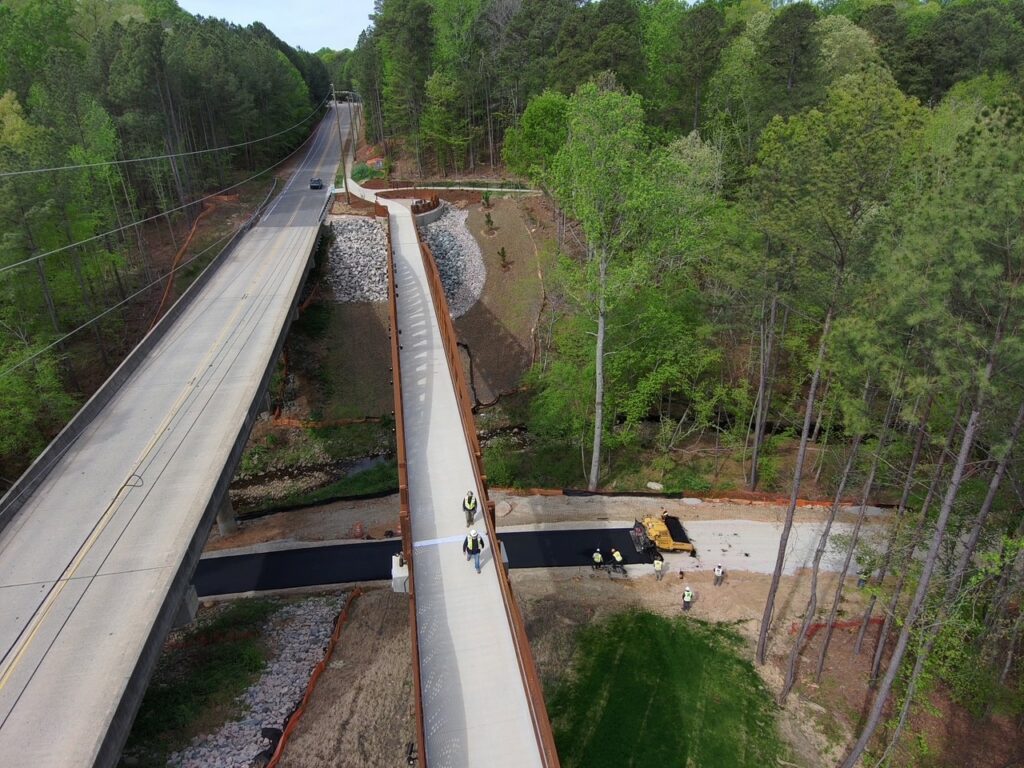

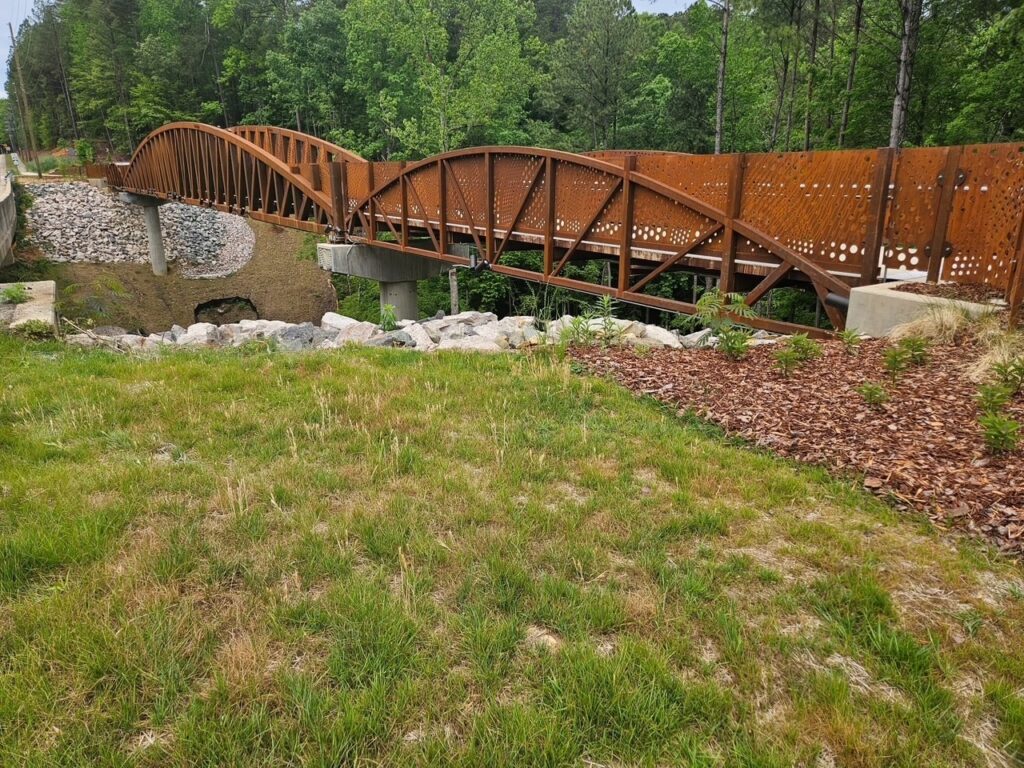

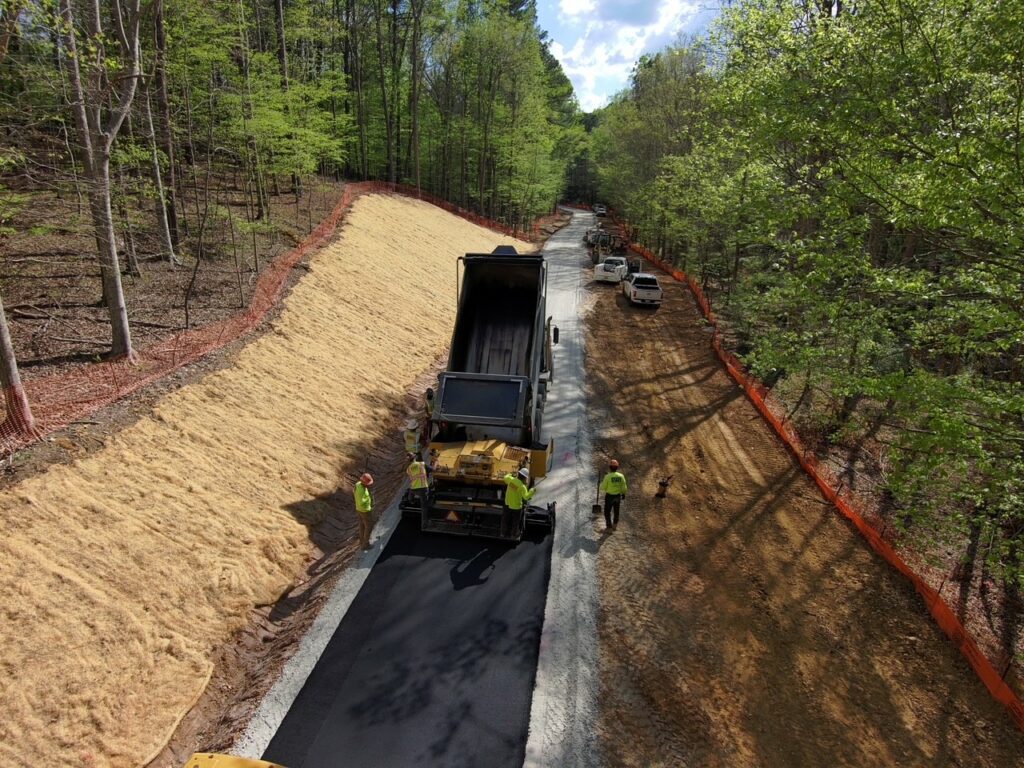

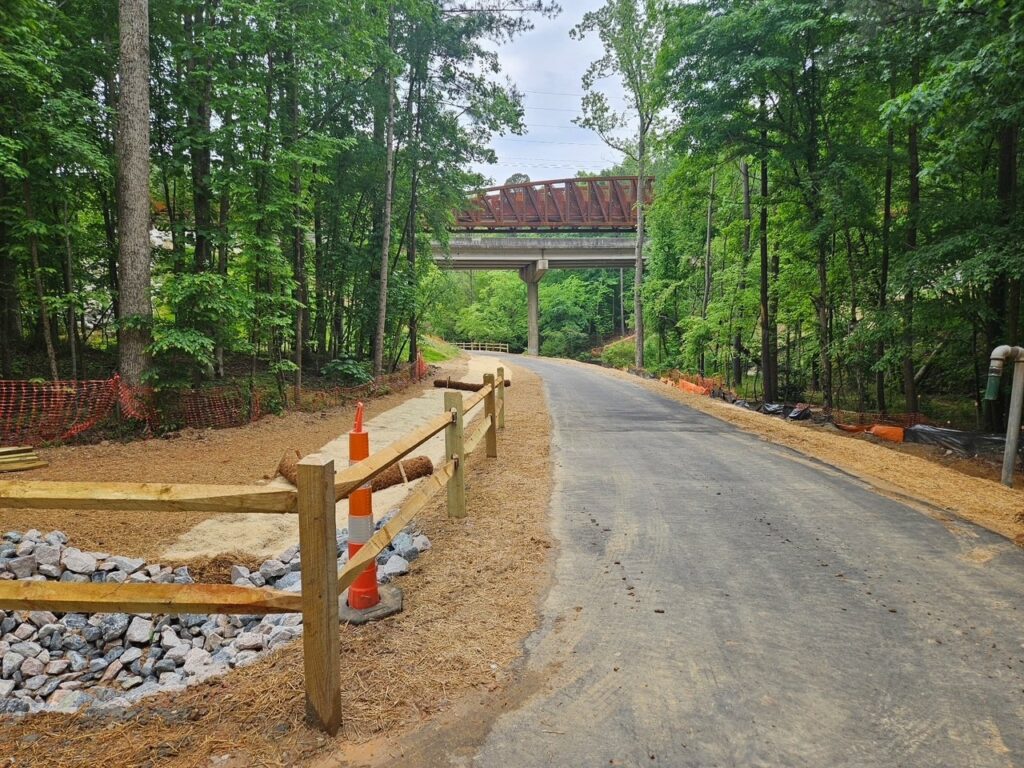

Greenway bridge installations are underway and will continue throughout the month of May. Preparations for the delivery and installation of the Cary Parkway pedestrian bridge at Black Creek are being planned for mid-June.




Phase 1 Construction Update – March/April 2025

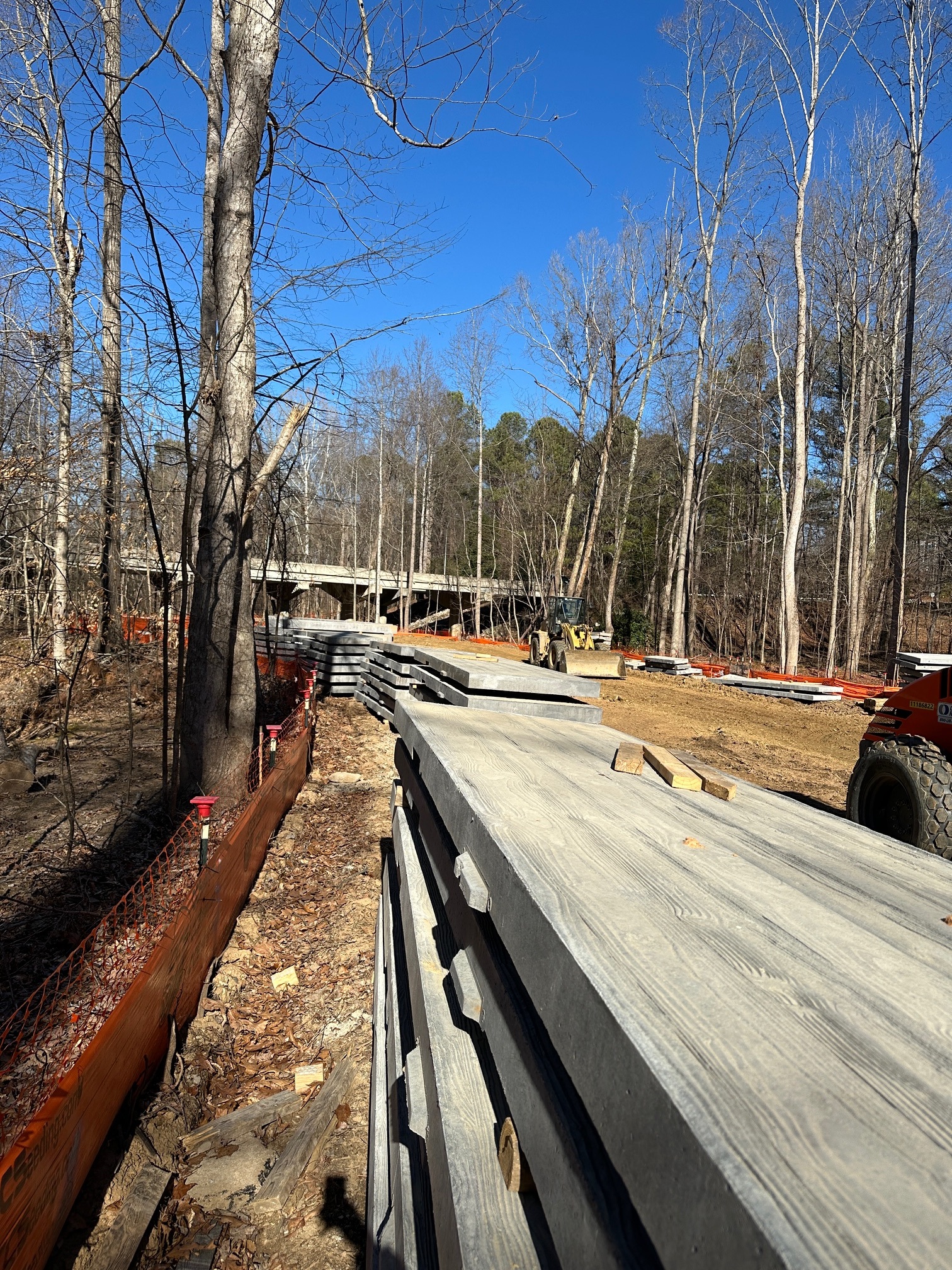

Phase 1 Construction Update – January/February 2025

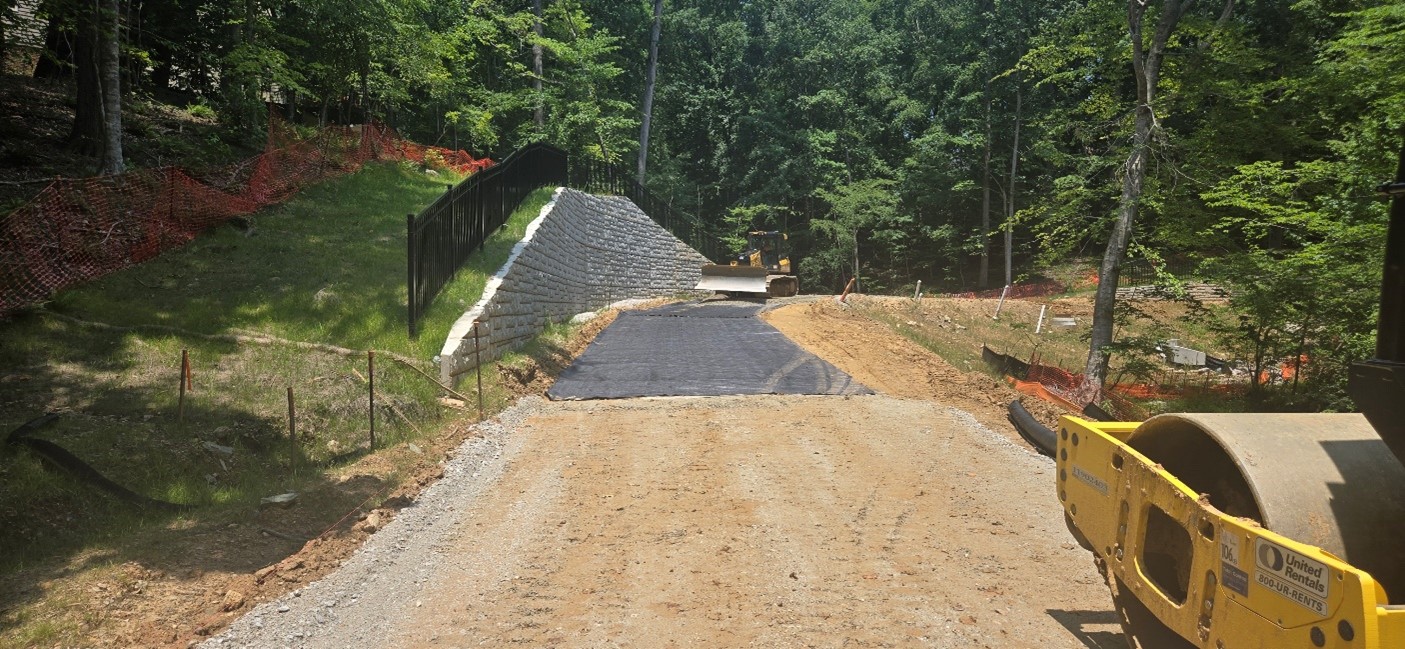

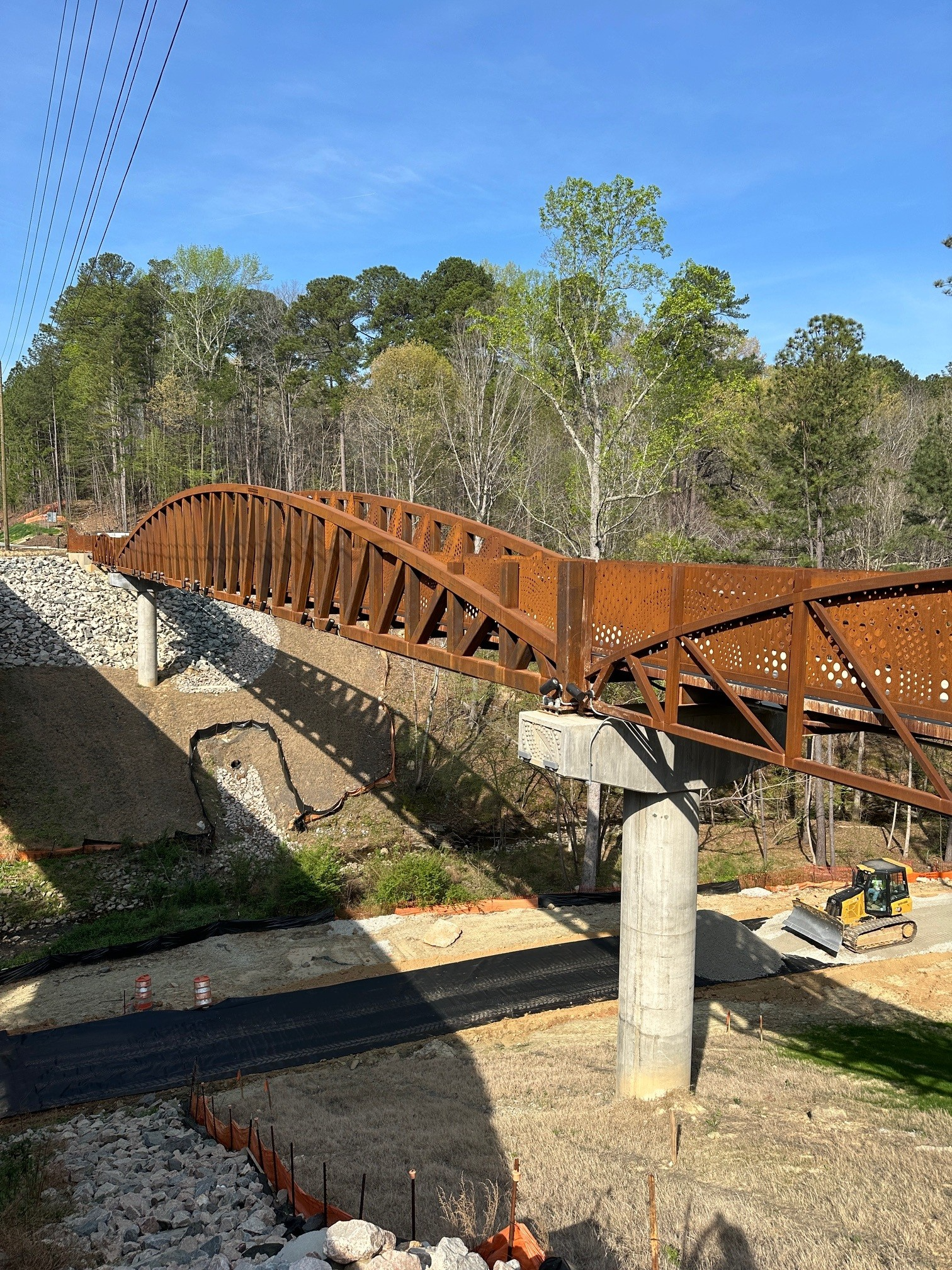

Construction has continued to focus on culvert, retaining wall and bridge foundation installations. Greenway bridges are scheduled to be delivered beginning in April and installation will continue throughout this spring. The Cary Parkway pedestrian bridge at Black Creek has been approved by NCDOT and fabrication is underway.

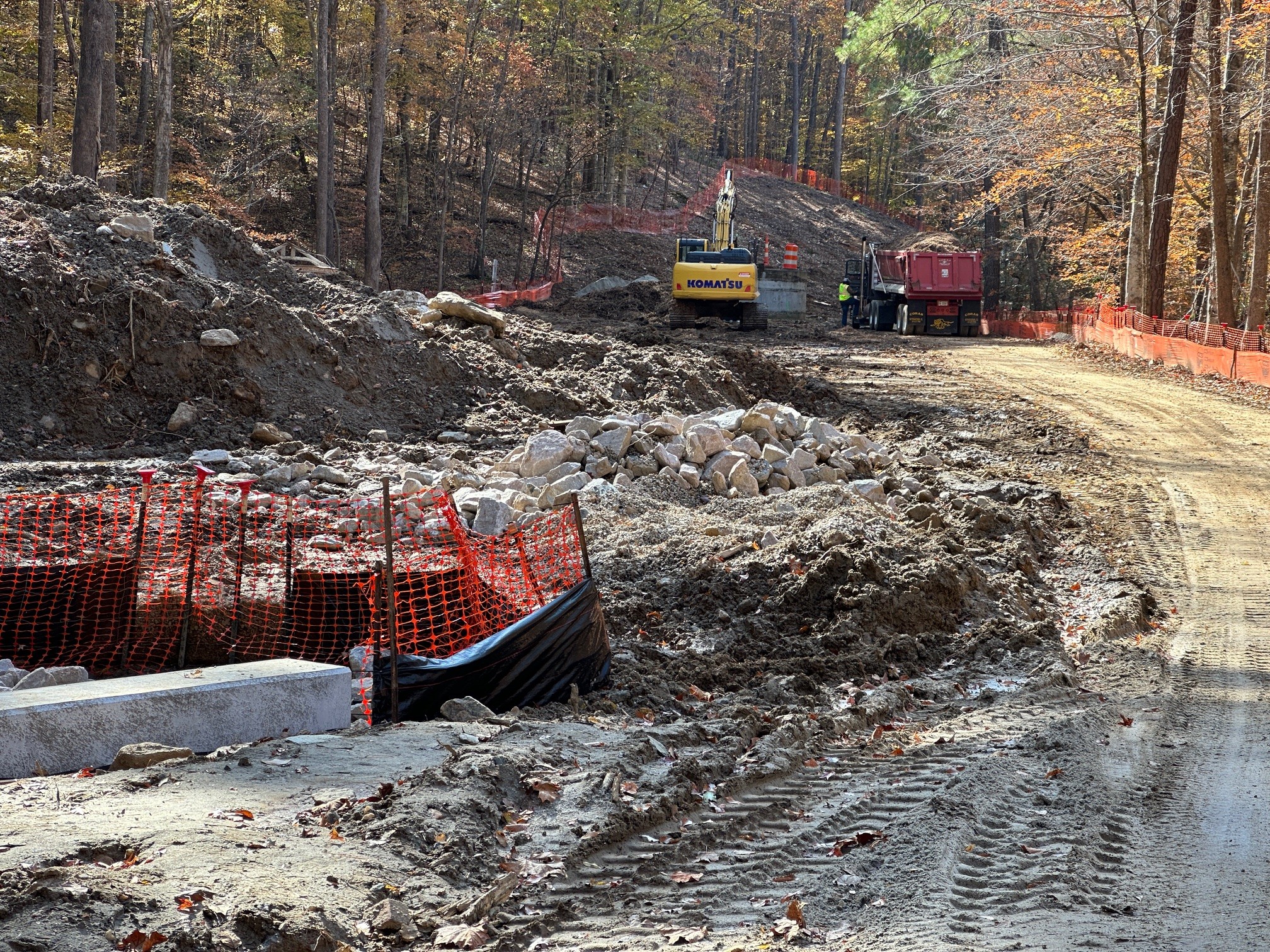

Phase 1 Construction Update – November/December 2024
As 2024 comes to a close, we wanted to provide a final project update for this year. We are happy to report construction is on schedule and good progress is being made including retaining wall installation and foundation installation for several pedestrian bridges. Phase 1 construction includes 5 pedestrian bridges along Black Creek Greenway that are currently being fabricated. The structural design for the Cary Parkway pedestrian bridge at Black Creek is under review by NCDOT and scheduled for fabrication to begin in early 2025.



Phase 1 Construction Update – September/October 2024
We have experienced significant rain events since the last construction update. Utility relocations and waterline installation along Cary Parkway have been completed. Storm drainage installation and grading operations are ongoing. Upcoming construction activities include foundation installations that will support new greenway bridges.
Phase 1 Construction Update – August 2024
Construction activities during July and August have been focused on clearing and grading along Black Creek Greenway and overhead utility relocations along Cary Parkway. The utility relocations are required in order to make room to install the new pedestrian bridge that will be installed next to Cary Parkway. Upcoming construction activities will focus on storm drainage installation and waterline installation.


Phase 1 Construction Update – July 2024
Construction started on June 3rd, 2024. In advance of beginning construction, Cary staff worked with the North Carolina Native Plant Society to relocate several plants along phase 1 of the project.
Construction activities during the month of June included setting up greenway detours, clearing construction limits, installation of erosion control devices and temporary stream crossings.
Upcoming construction activities include temporarily relocating overhead utilities along Cary Parkway, grading and installation of drainage structures.


Timeline – Construction Phases

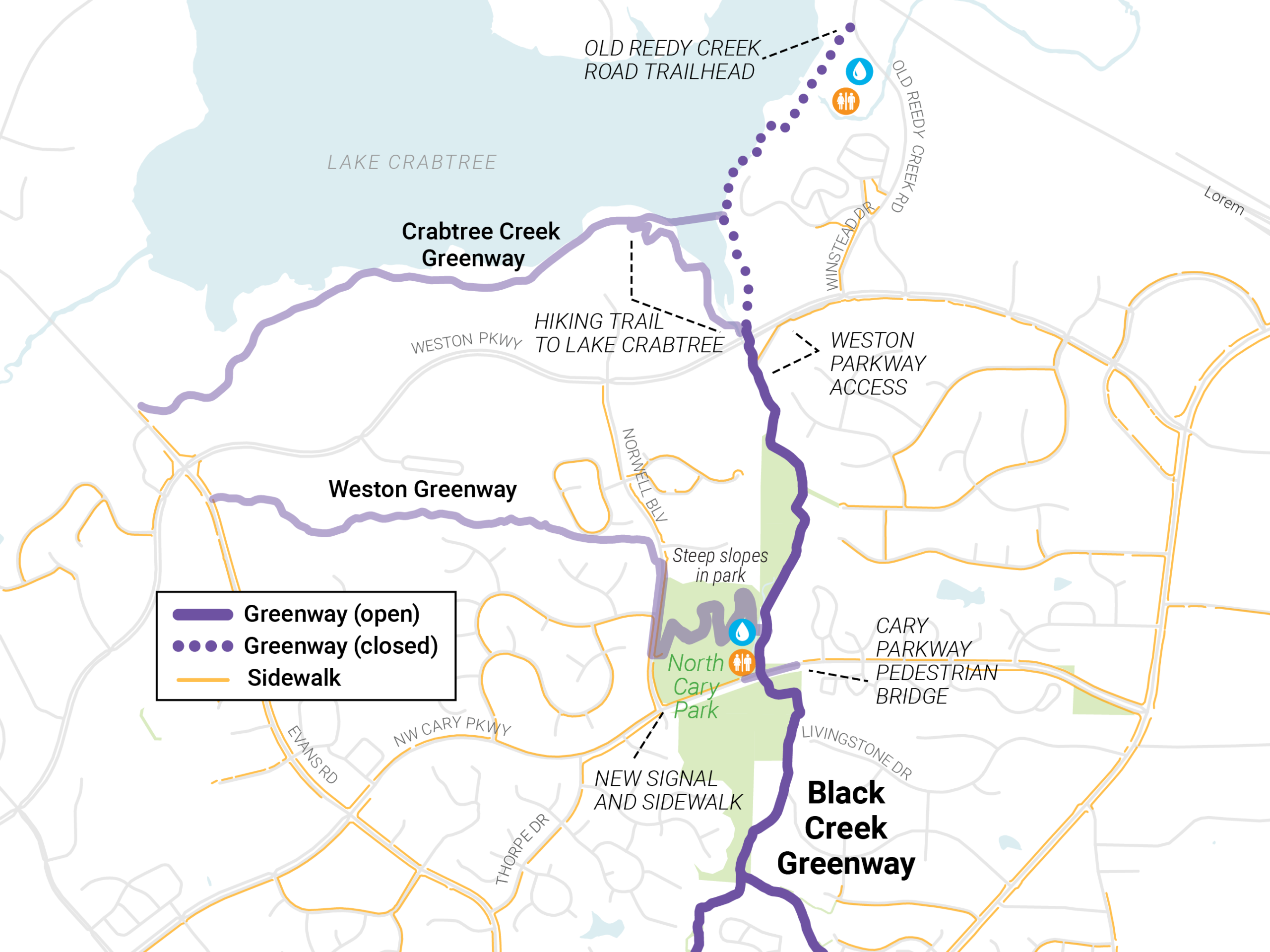

The construction phases for the Black Creek Greenway reconstruction will be in three separate parts.
1
West Dynasty Drive to North Cary Park
2024 – 2025
2
North Cary Park to Weston Parkway
2025 – 2026
3

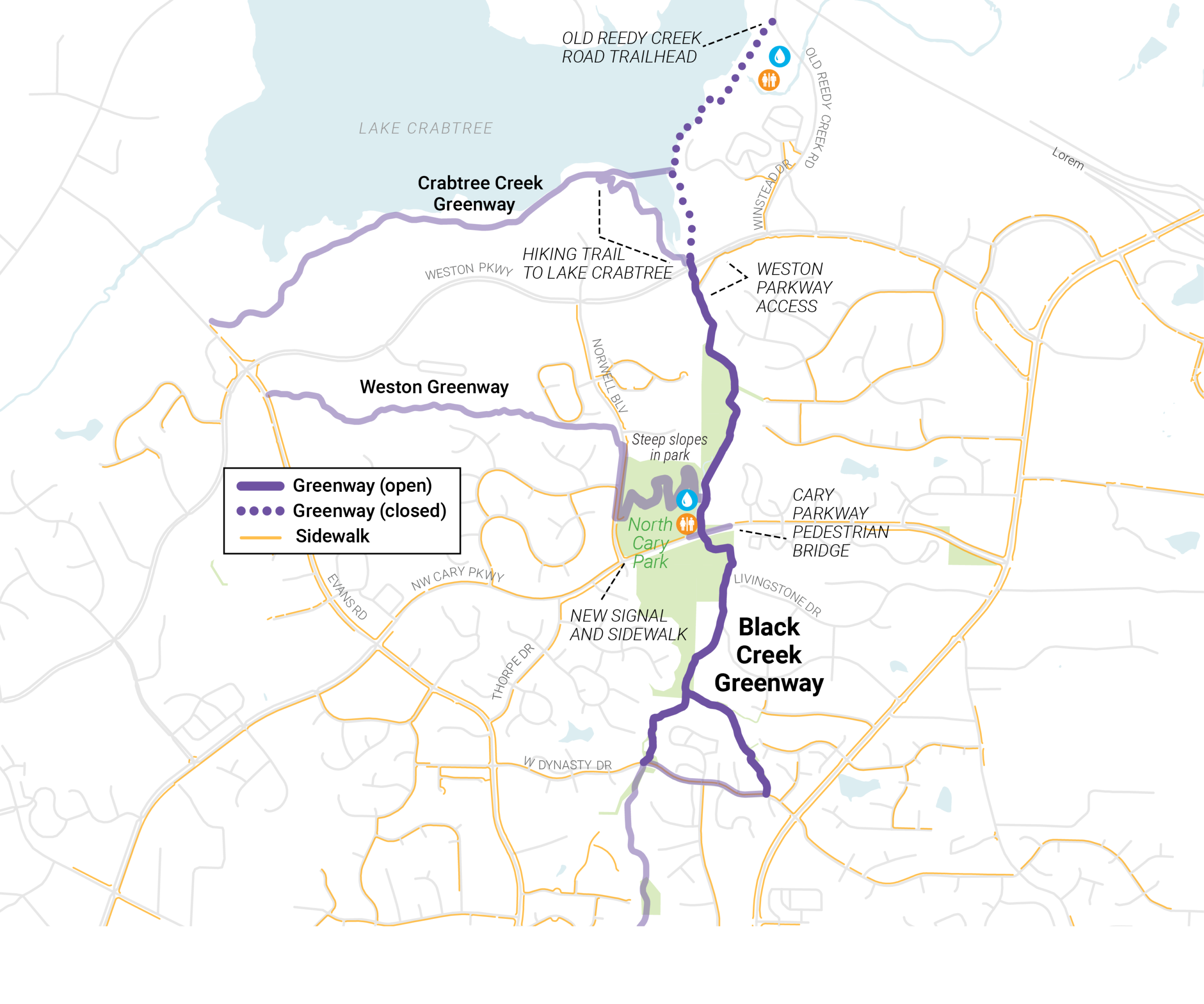

Weston Parkway to Old Reedy Creek Road Trailhead
2026 – 2027
